Dobie Middle School

""

Dobie Middle School will receive a Phase 1 (of 2-3) modernization as part of the 2022 Bond. The project design is anticipated to begin in fall 2023 and open in spring 2026. The Campus Architectural Team, composed of campus staff, parents and community members, will work with the district and project team to determine the scope of the modernization in order to best meet the needs of Dobie’s students, staff and community. Dobie will also receive a secure entry vestibule and improvements to HVAC, electrical, roofing and plumbing.

As a part of the turnaround planning for Dobie Middle School, the Bond project team was tasked with additional improvements to the main building beyond the original Bond project scope to be completed in Summer 2025. These improvements include:

  1. Removal of Cafeteria stage rigging and lofts to improve student safety
  2. Replace all student restroom partitions to address privacy issues
  3. Removal of all locker rooms across the hallways
  4. Cut opening and addition of a door to access the serving lines from the Cafeteria
  5. Patch and paint of hallway walls
  6. Replace hallway ceiling tiles

Dobie Middle School will be utilized as a swing space for Wooldridge Elementary. Wooldridge Elementary is being fully modernized through the 2022 Bond. While Wooldridge Elementary is under construction, those students will temporarily relocate to portables at Dobie Middle School. During this process, Dobie and Wooldridge will remain separate school communities with their own teachers, staff and facilities.

Follow the links to view the campus FAQs in English and Spanish.

Dobie Middle School logo

Project Status

Project Details

Total Project Budget: $36,843,000

Anticipated Opening Date: January 2026

Trustee: Candace Hunter

Location: 1200 E Rundberg Ln., Austin, TX 78753

Program Manager: VANIR|STV

Architecture & Engineering: Pfluger Architects

Construction: S&P Construction, Inc.

Bond Financials

For in depth financial and project reporting visit our CBOC meetings page. The Board of Trustees appointed volunteer community members to the Community Bond Oversight Committee (CBOC) to ensure that the projects remain faithful to the voter-approved bond program scope of work and to monitor and ensure the bond projects are completed on time, with quality and within budget.

Milestones

Construction Updates

Q4 2025 Updates:

Completed Activities:

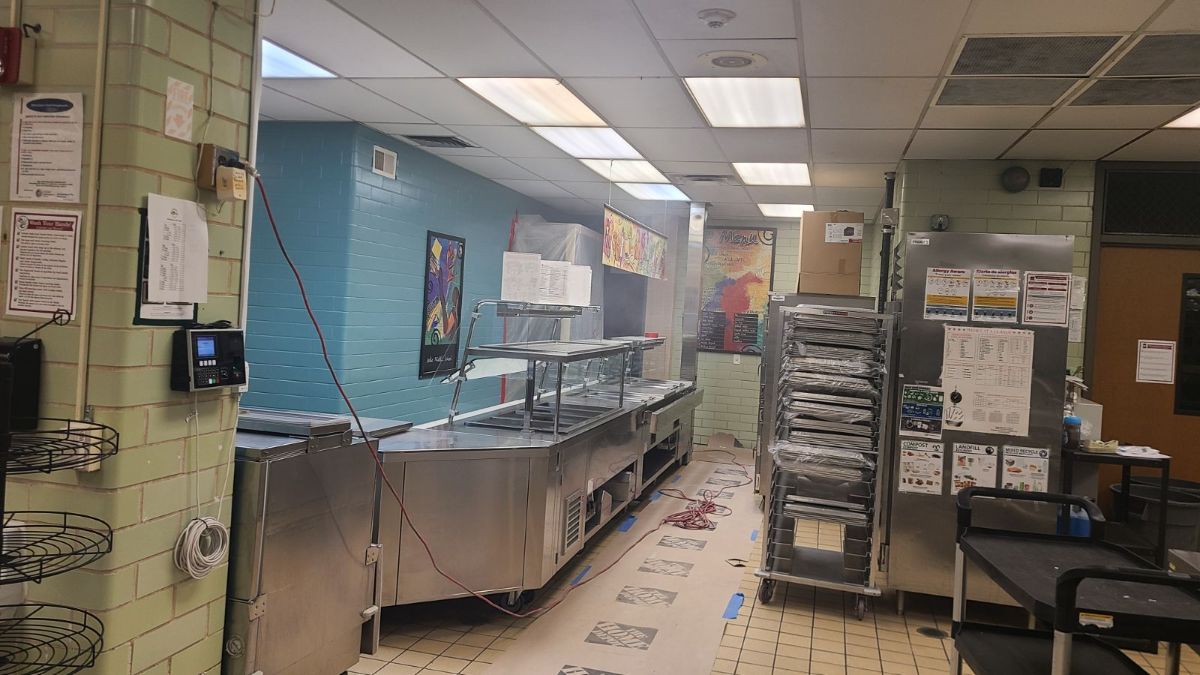

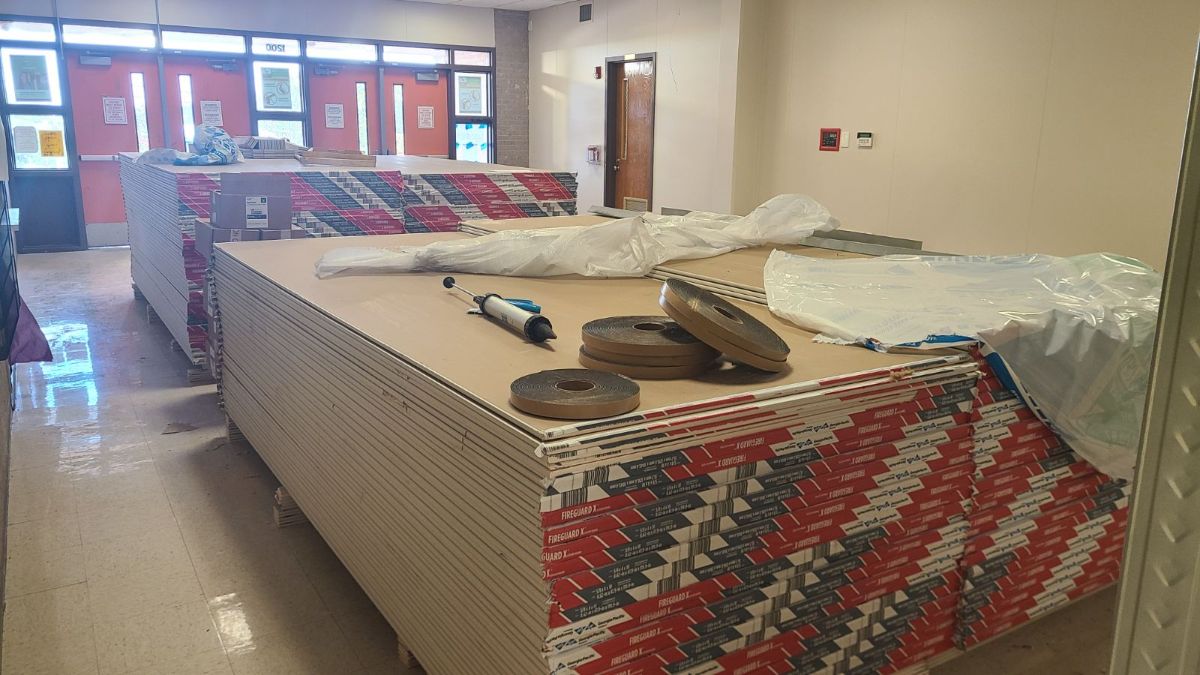

  • Interior painting
  • Locker removal
  • Ceiling tile replacement
  • Temporary front desk installed
  • Replaced all student restroom partitions

On-going Activities:

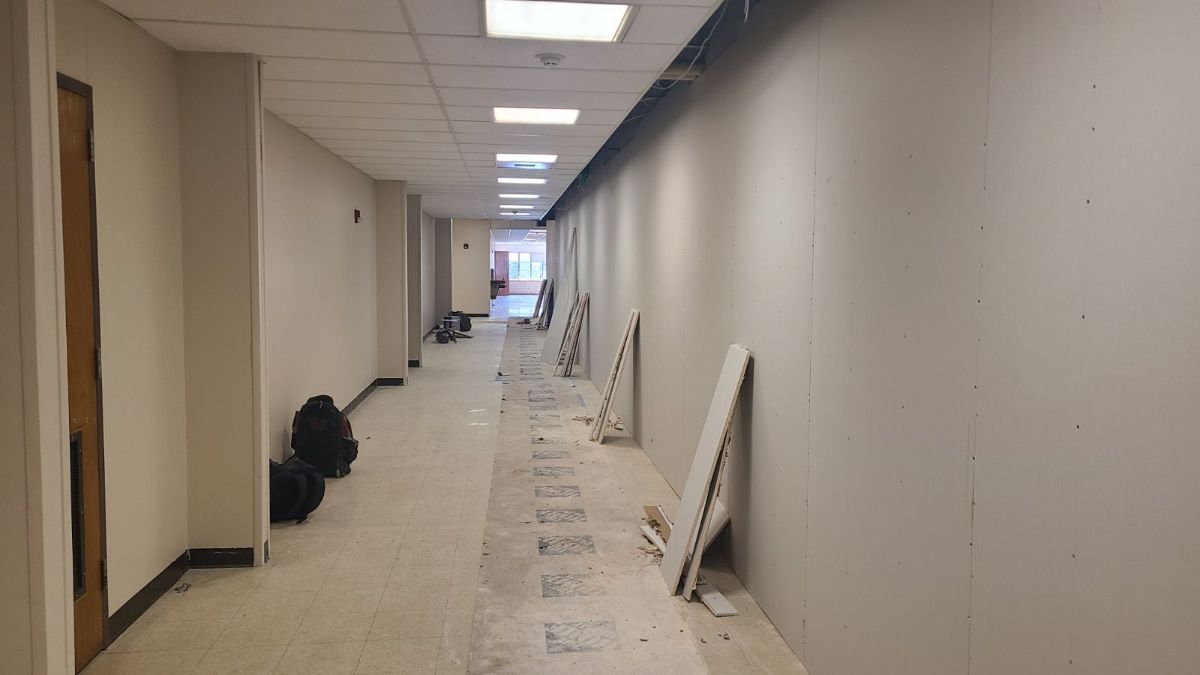

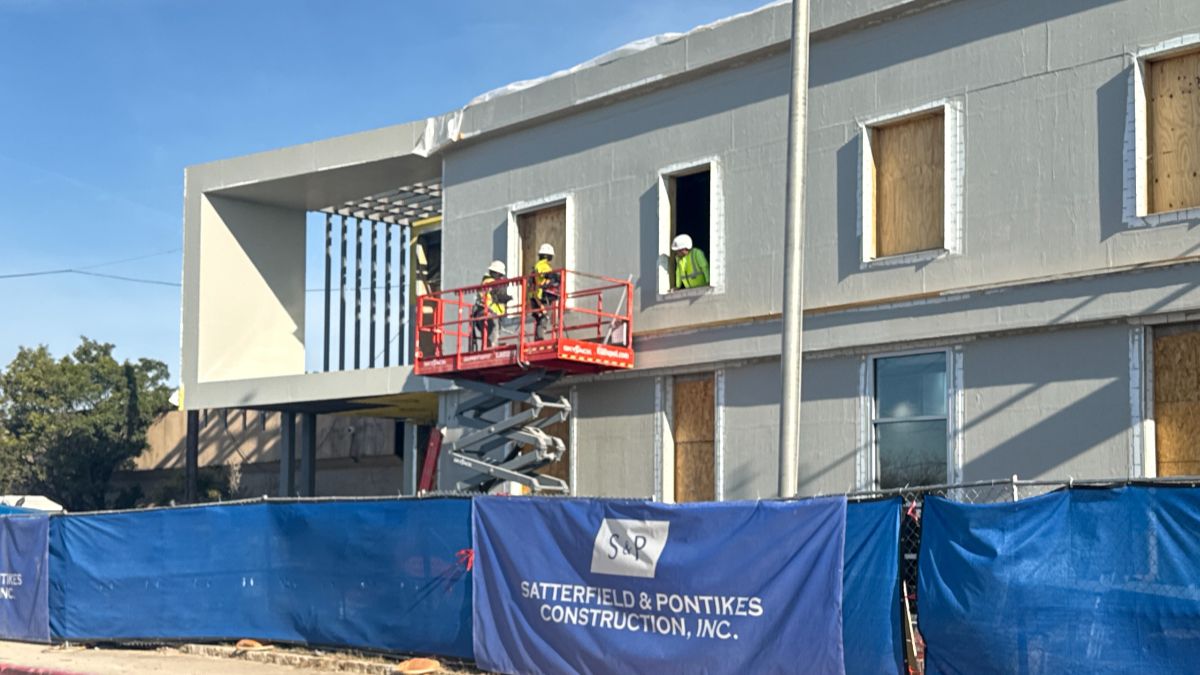

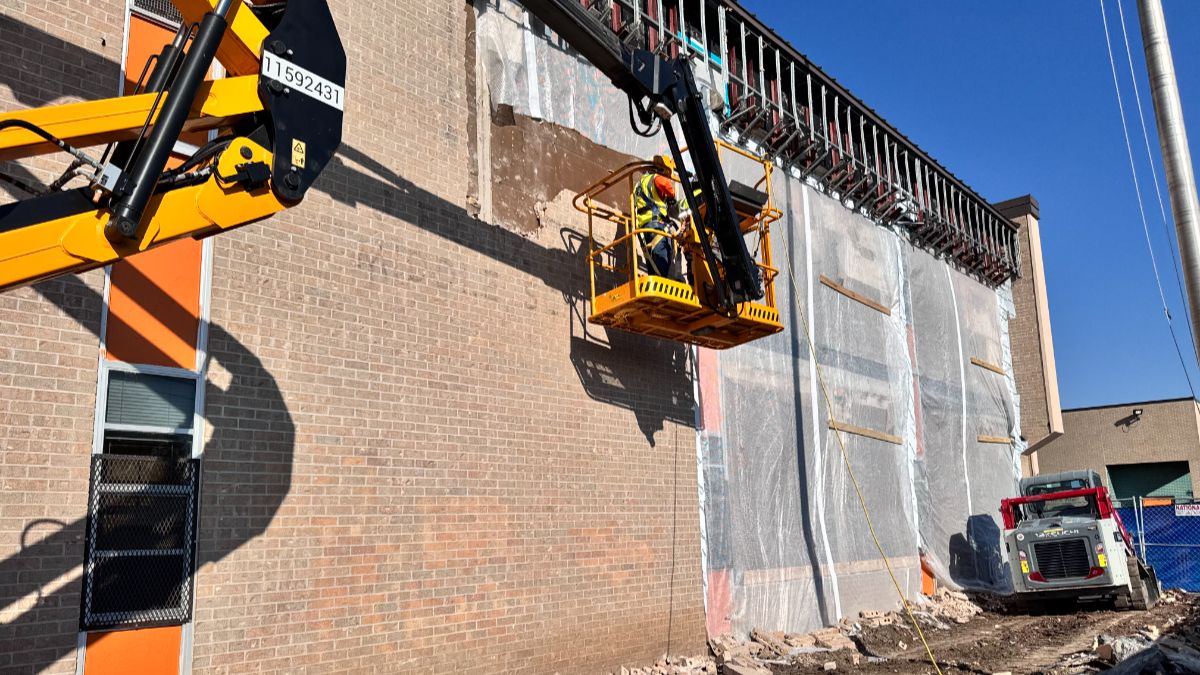

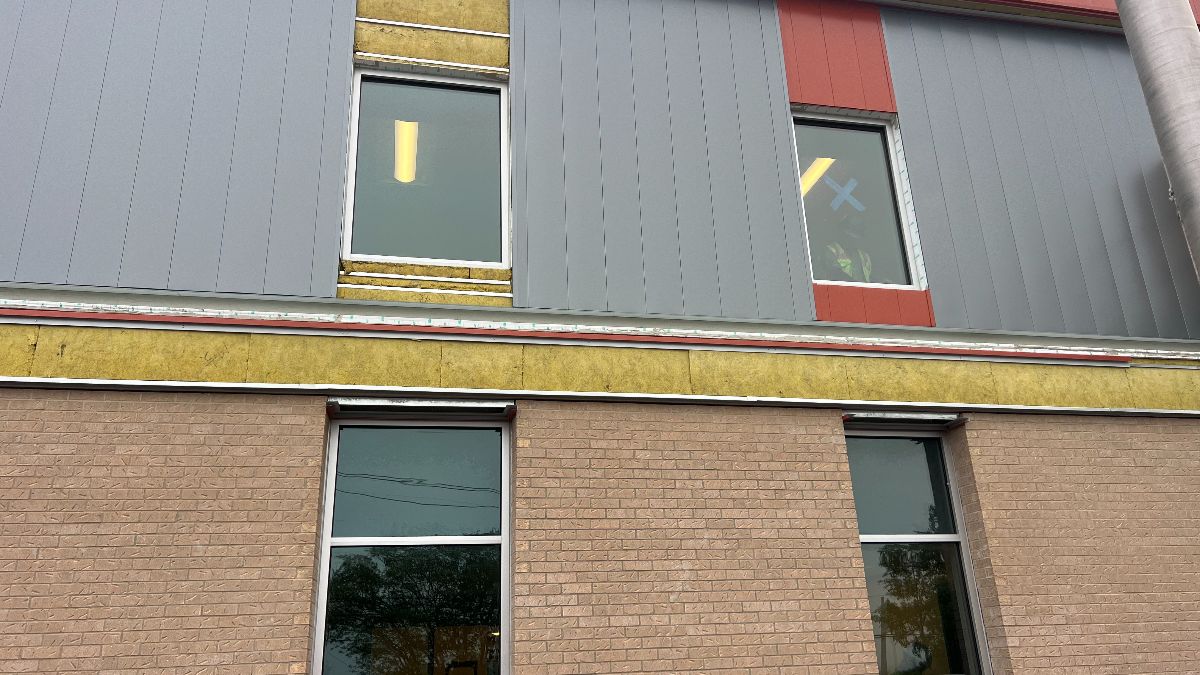

  • Demolition of exterior facade underway

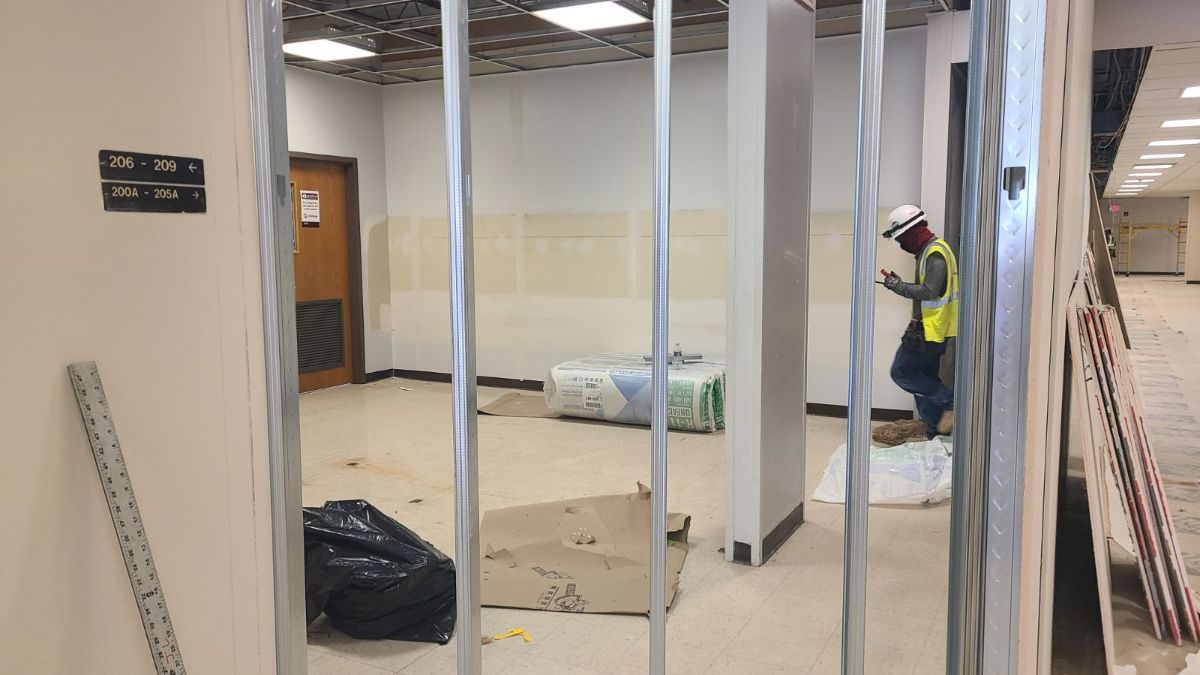

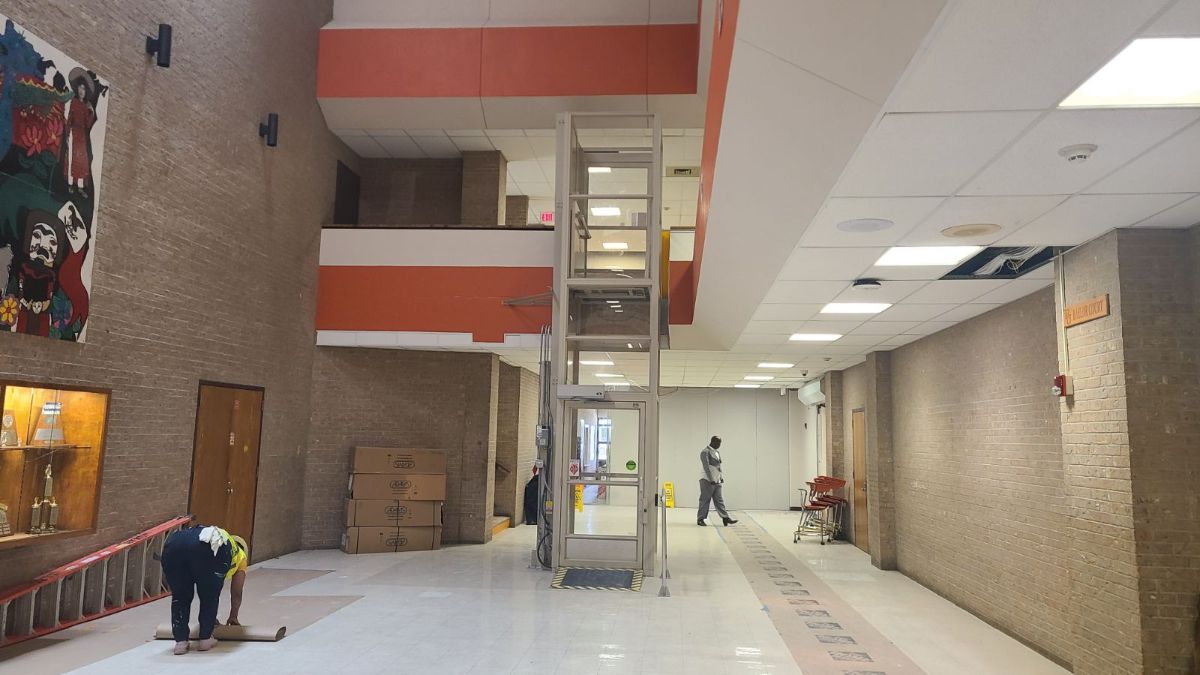

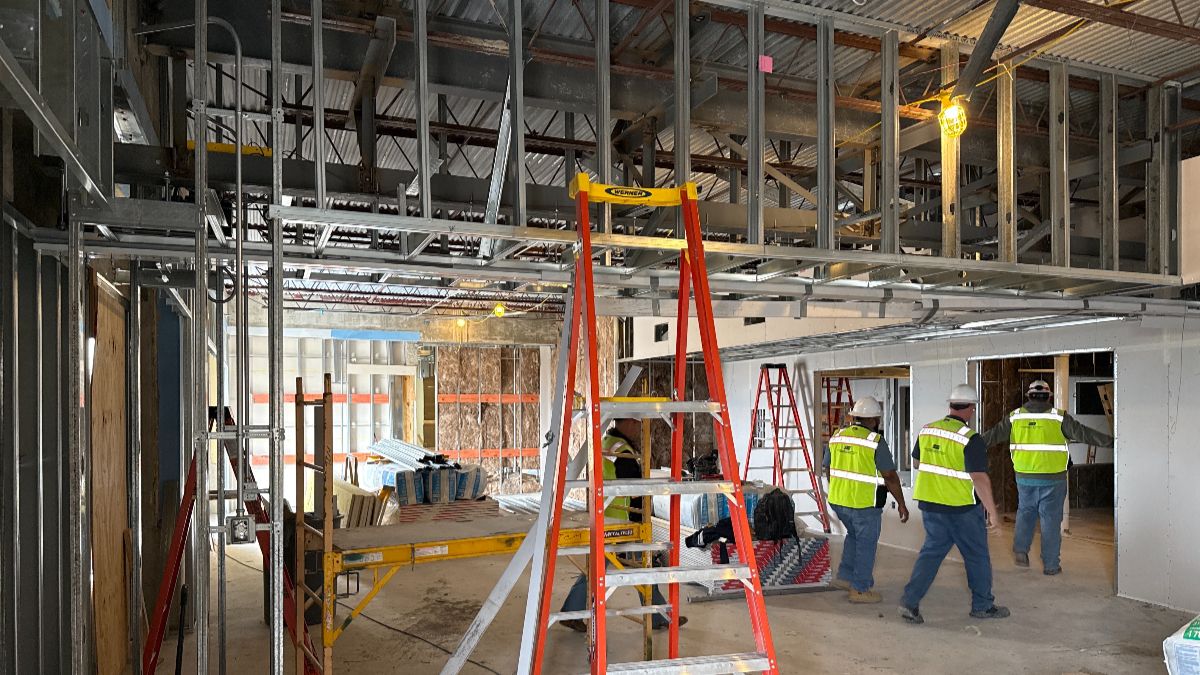

  • Demolition & construction underway for new secure vestibule

Upcoming Activities:

  • Demolition & construction of basketball court & tennis courts

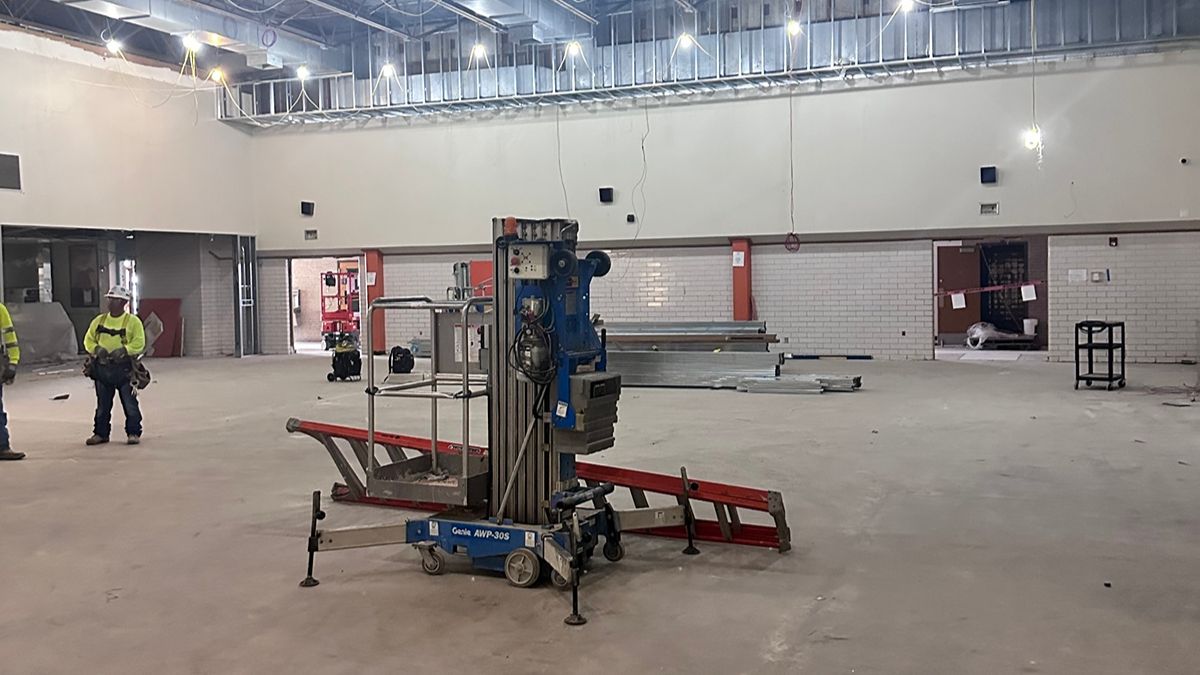

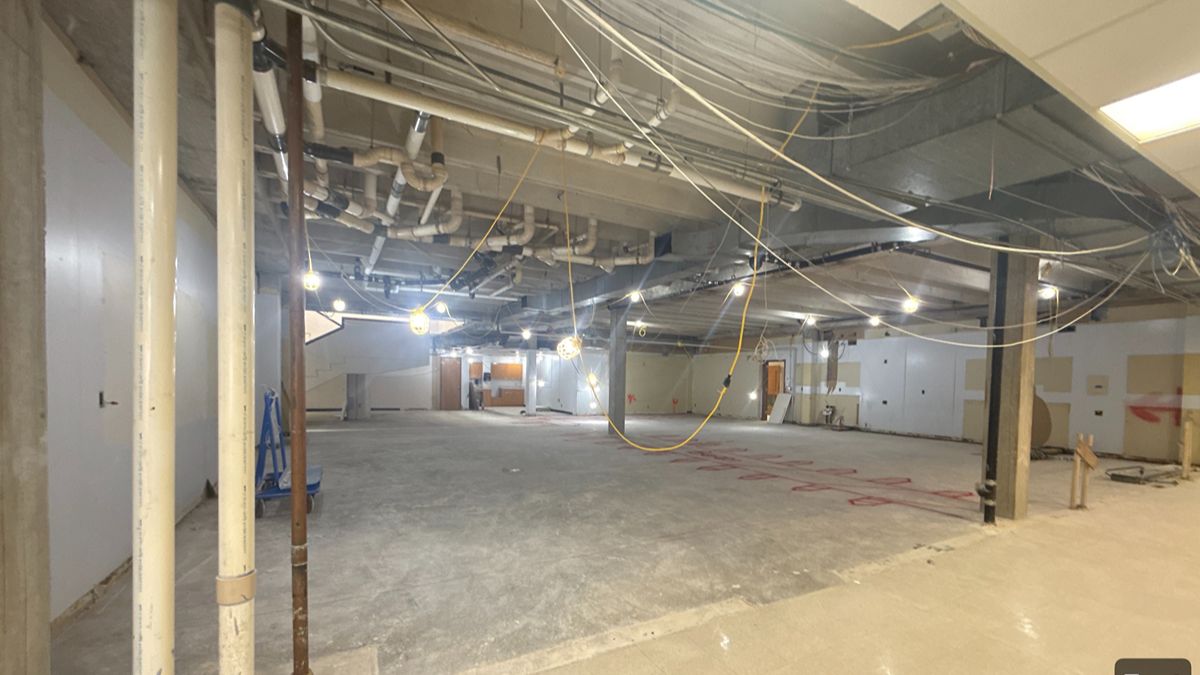

  • Empower center, cafeteria, and community spaces to be renovated starting in June 2026
